Calculate the Early Start, Early Finish, Late Start, Late Finish, and slack for project activities using network analysis.
Business/Management
ScanSolve AI Answer
Step-by-step solution
3 stepsHere are the calculations for the project activities:

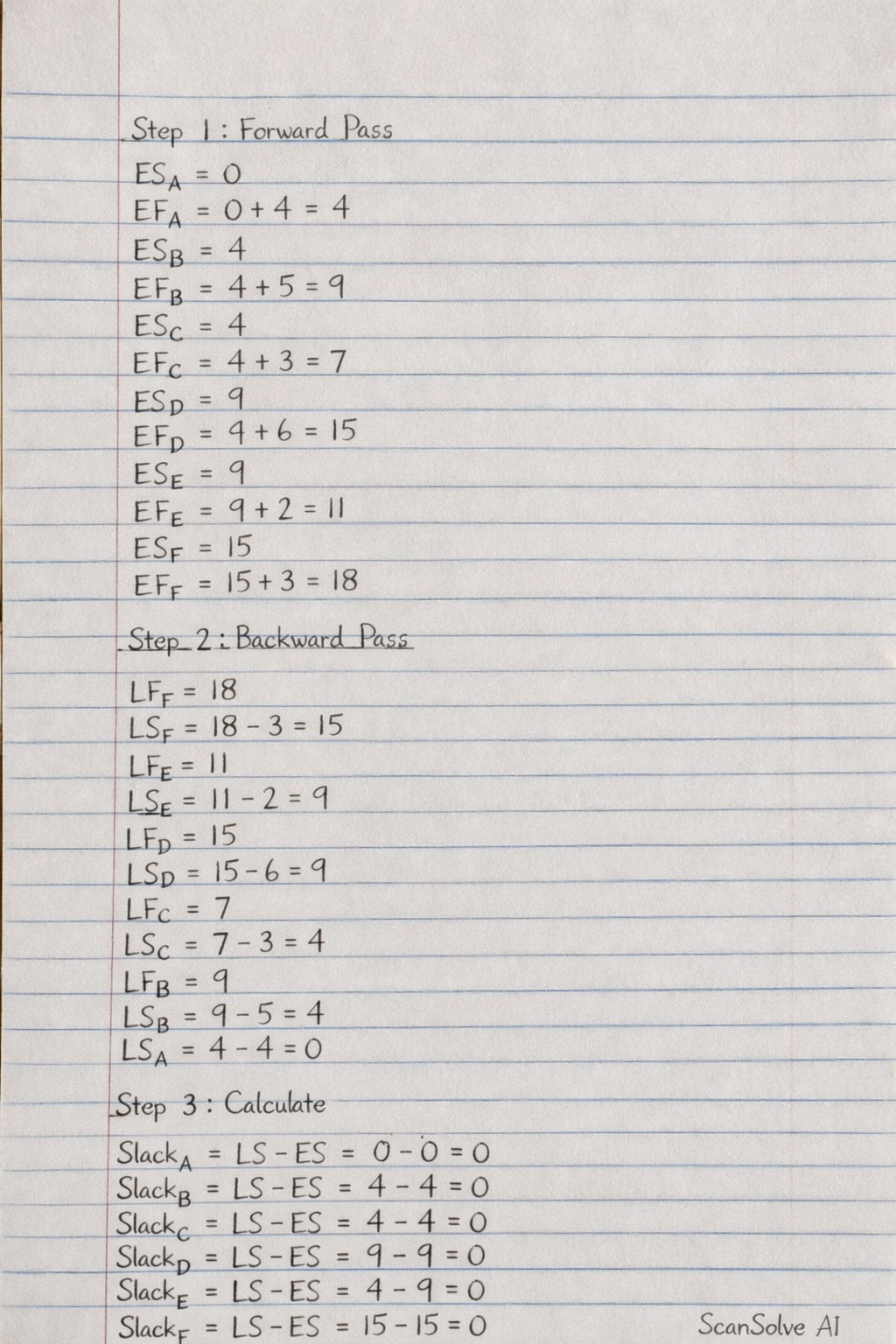

i. The Early Start, Early Finish, Late Start, Late Finish and the slack for all the activities
Perform a forward pass to calculate Early Start (ES) and Early Finish (EF) for each activity.
Perform a backward pass to calculate Late Finish (LF) and Late Start (LS) for each activity.
The project completion time is the maximum EF of all final activities.
Calculate
Was this helpful?
Still stuck on this one?
Ask a follow-up, and the answer starts from this question.
Got a different question?Ask your own question
More Business/Management Questions
QCalculate the Early Start, Early Finish, Late Start, Late Finish, and Slack for each activity, and…QCreate a PERT network diagram to represent the project schedule and calculate the Early Start, Early…QAnalyze the provided project schedule using PERT, calculating ES, EF, LS, LF, and Slack for each…QDifferentiate between lag time and slack time, and critical path and critical path driven delay in…Q& (ii) The activity list and their durations are required to draw the network diagram and determine…

Handwritten Step-by-Step Solution
Get this as a handwritten image on WhatsApp — like a tutor wrote it for you.
Try on WhatsApp
